Blog

Construction Process Flow Chart for Pile Foundation Work

Section 1: Construction Preparation

Site Leveling

  1. Before excavation, ensure the site is fully prepared with access to water, electricity, and proper leveling (Three Supplies and One Leveling).

  2. Remove all obstacles such as underground cables, pipelines, and equipment foundations.

  3. Set up temporary facilities, including power, water, and safety measures.

  4. Review construction drawings and understand subsurface soil and hydrogeological conditions.

  5. Conduct safety inspections and tests on cranes and other equipment before operation.

  6. Level the site according to design elevation requirements, clearing all debris (rocks, tree roots, garbage, etc.). Fill and compact low-lying areas.


Section 2: Survey and Positioning

  1. Establish on-site control points using a total station based on coordinates provided by planning authorities.

  2. Verify control points with the client and supervising engineer before proceeding with axis, pile positioning, and elevation control.

  3. Protect control points with concrete foundations and warning signs to prevent displacement.

  4. Conduct preliminary and secondary pile position surveys before and after installing guide sleeves.

  5. Mark pile positions with Φ12 rebar and verify sleeve and ground elevation using a level.

  6. Obtain approval from the client and supervising engineer before commencing drilling.


Section 3: Guide Sleeve Installation

Key Requirements:

  1. The sleeve must be accurately positioned, with a center deviation ≤20mm and inclination ≤1%.

  2. Sleeves are typically made of 4–8mm steel plates, with an inner diameter 200mm larger than the designed pile diameter.

  3. Minimum sleeve embedment depth:

    • 1.5m in cohesive soil

    • 2.0m in sandy soil

  4. The sleeve top should extend 30cm above ground level.

Functions of Guide Sleeves:

  • Protects the borehole opening

  • Guides drilling alignment

  • Isolates surface water

  • Maintains water head to prevent collapse

  • Secures the reinforcement cage

Cross-Marking for Alignment

  • Set four reference points (Φ20 rebar) in a cross pattern 1–2m outside the sleeve.

  • Secure reference points with 20 cm-thick concrete and mark with red paint for visibility.


Section 4: Drilling Rig Setup

Rig Installation

  1. Place the rig on stable sleepers to prevent shifting or tilting.

  2. Ensure the drill bit center aligns with the sleeve center (deviation ≤20mm).

  3. Maintain mud level 1m above groundwater (1.5m in fluctuating water tables).

Impact Drilling Advantages

  • Suitable for various geological conditions, especially gravel layers.

  • Creates a compacted borehole wall, enhancing stability and load-bearing capacity.

Mud Pump Function

  • Circulates drilling fluid to remove cuttings and supply power to downhole tools.


Section 5: Impact Drilling

Key Steps:

  1. Fill the sleeve with clay and water before drilling to form a mud wall.

  2. Adjust mud properties:

    • Density ≤1.25

    • Viscosity: 18–20s

    • Sand content ≤6%

  3. Verify the rock interface and final borehole depth with samples.

  4. Start with low-impact (0.4–0.6m height), then increase to 1.5–2.0m.

  5. Check verticality every 1–2m; correct deviations immediately.


Section 6: Primary Hole Cleaning

Procedure:

  1. After drilling, lower the mud hose to the bottom for circulation.

  2. Pump fresh mud to reduce sand content (≤6%) and density (≤1.25).

  3. Ensure sediment thickness ≤50mm before proceeding.

Final Hole Inspection

  • Verify hole diameter, depth, verticality (≤1%), and sediment thickness with the client and supervising engineer.


Section 7: Reinforcement Work

7.1 Rebar Inspection

  1. Check manufacturer certifications and test reports.

  2. Conduct mechanical property tests on samples.

  3. For seismic zones, ensure:

    • Tensile-to-yield strength ratio ≥1.25

    • Yield-to-standard strength ratio ≤1.3

7.2 Cage Fabrication

  1. Weld or bind stirrups to main bars at 2m intervals.

  2. Limit joint overlaps to 50% of the total bars per section.

  3. Use mortar pads (≥3 per ring) for spacing control.

7.3 Installation

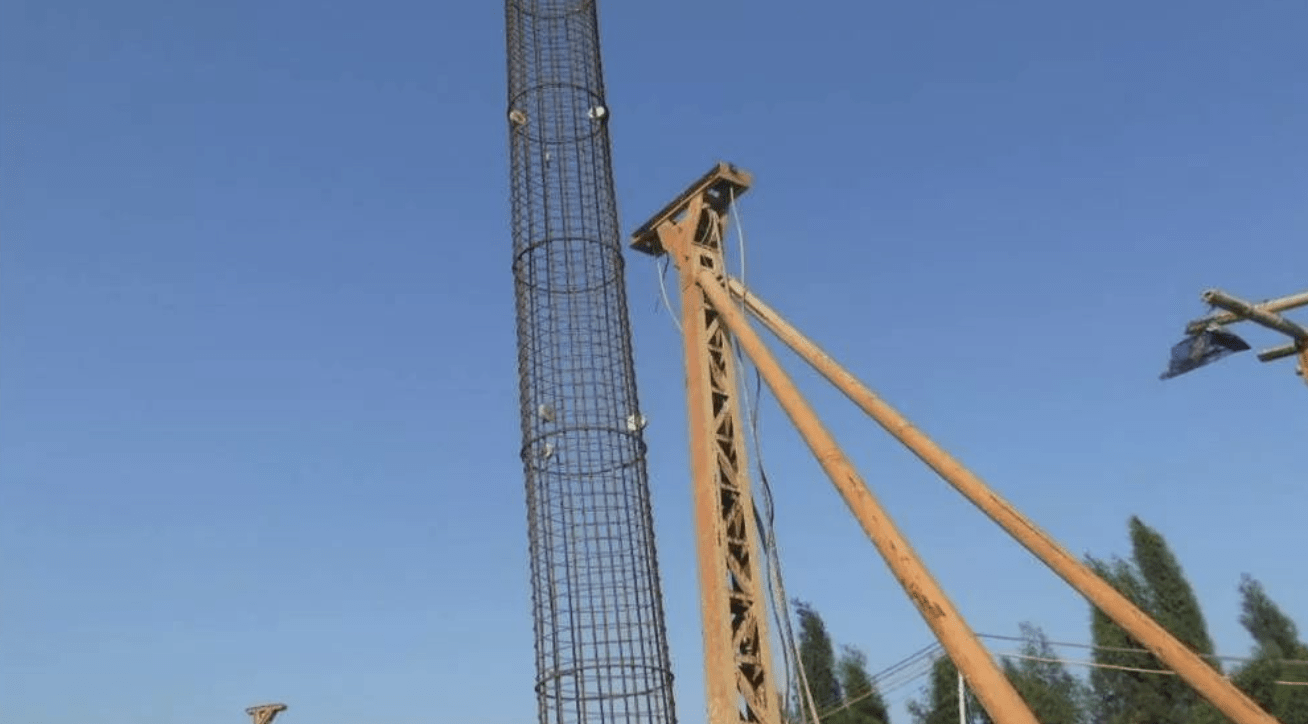

  1. Lift the cage with a crane using dual slings to prevent deformation.

  2. Align carefully to avoid borehole damage.

  3. Secure the top with calculated positioning bars.

7.4 Quality Standards

  • Length tolerance: ±100mm

  • Diameter tolerance: ±10mm

  • Verticality: ≤1%


Section 8: Secondary Hole Cleaning

Purpose:

Remove new sediment after cage/pipe installation.

Method:

  • Use mud replacement with constant pipe agitation.

  • Final checks:

    • Density ≤1.25

    • Sand content ≤6%

    • Sediment ≤50mm


Section 9: Concrete Pouring

Critical Controls:

  1. Use tremie pipes for underwater placement.

  2. The initial pour must cover the pipe end by 1.0–1.3m.

  3. Complete pouring within 2–4 hours without interruptions.

  4. Maintain pipe embedment depth at 2–6m.

  5. Ensure slump: 160–220mm.


Section 10: Key Process Checkpoints

  1. Pile position verification

  2. Hole depth confirmation

  3. Rock interface and final depth approval

  4. Secondary hole cleaning

  5. Rebar quality approval

  6. Cage welding and placement

  7. Initial concrete pour


Section 11: Common Defects & Solutions

11.1 Position Deviation

Cause: Incorrect marking or rig misalignment.
Fix: Double-check coordinates before drilling.

11.2 Borehole Tilting

Cause: Uneven ground or underground obstacles.
Fix: Level the site and clear obstructions.

11.3 Necking

Cause: Wall collapse or fast pipe extraction.
Fix: Optimize mud viscosity and control lifting speed.

11.4 Hole Collapse

Cause: Weak mud or excessive drilling speed.
Fix: Use high-quality mud and adjust drilling parameters.

11.5 Excessive Sediment

Cause: Soil fall-in or delayed pouring.
Fix: Clean promptly and pour concrete immediately.

11.6 Cage Floating

Cause: Upward concrete pressure.
Fix: Secure the cage and control the pouring rate.

11.7 Pipe Leakage

Cause: Insufficient initial concrete or faulty seals.
Fix: Remove debris and reseal joints.

11.8 Pipe Blockage

Cause: Poor concrete mix or equipment failure.
Fix: Use vibrators or replace pipes.

11.9 Pipe Burial

Cause: Excessive embedment depth.
Fix: Limit depth to 6–8m.

11.10 Broken Pile

Cause: Concrete segregation or interruptions.
Fix: Ensure continuous pouring and proper mix design.
